Supply chain risk management is the discipline of finding vulnerabilities before they become customer failures. It moves the organization beyond availability bias, where recent disruptions receive too much attention and quiet structural risks remain invisible. A strong SCRM system defines the risk taxonomy, scores probability and impact, assigns owners, funds mitigation with business logic, and prepares the first 24 hours of response.

Guide 8 covers the seven pillars of supply chain risk, probability-impact scoring, risk heat maps, expected annual loss, treatment choices, resilience strategies, supply chain FMEA, live risk registers, recovery objectives, war-room response, customer communication, and the Meridian near-miss lesson that converted excess inventory into a formal risk management program.

Download the PDF guide Back to SCM series

Back to Guides

Visual Summary

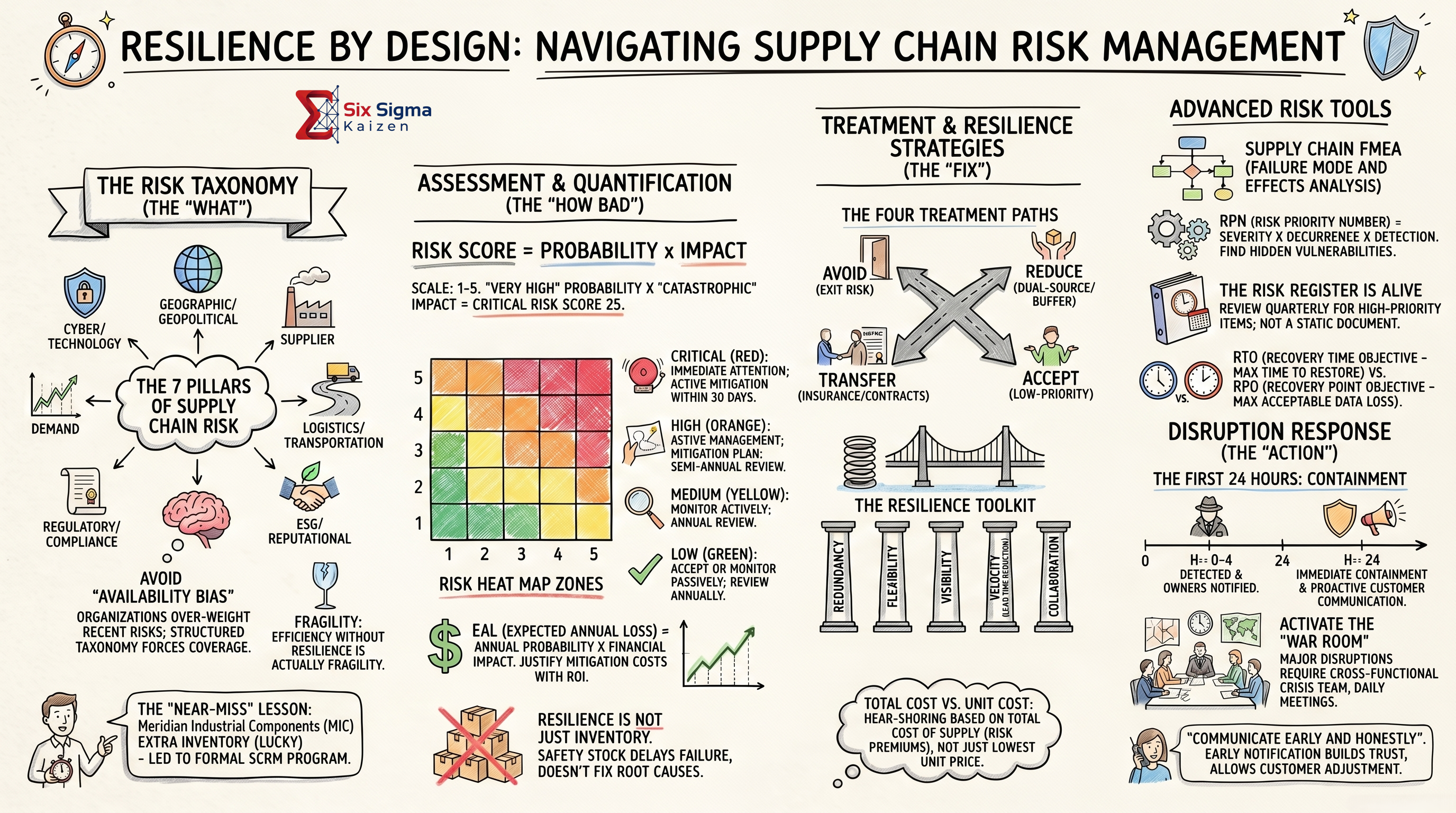

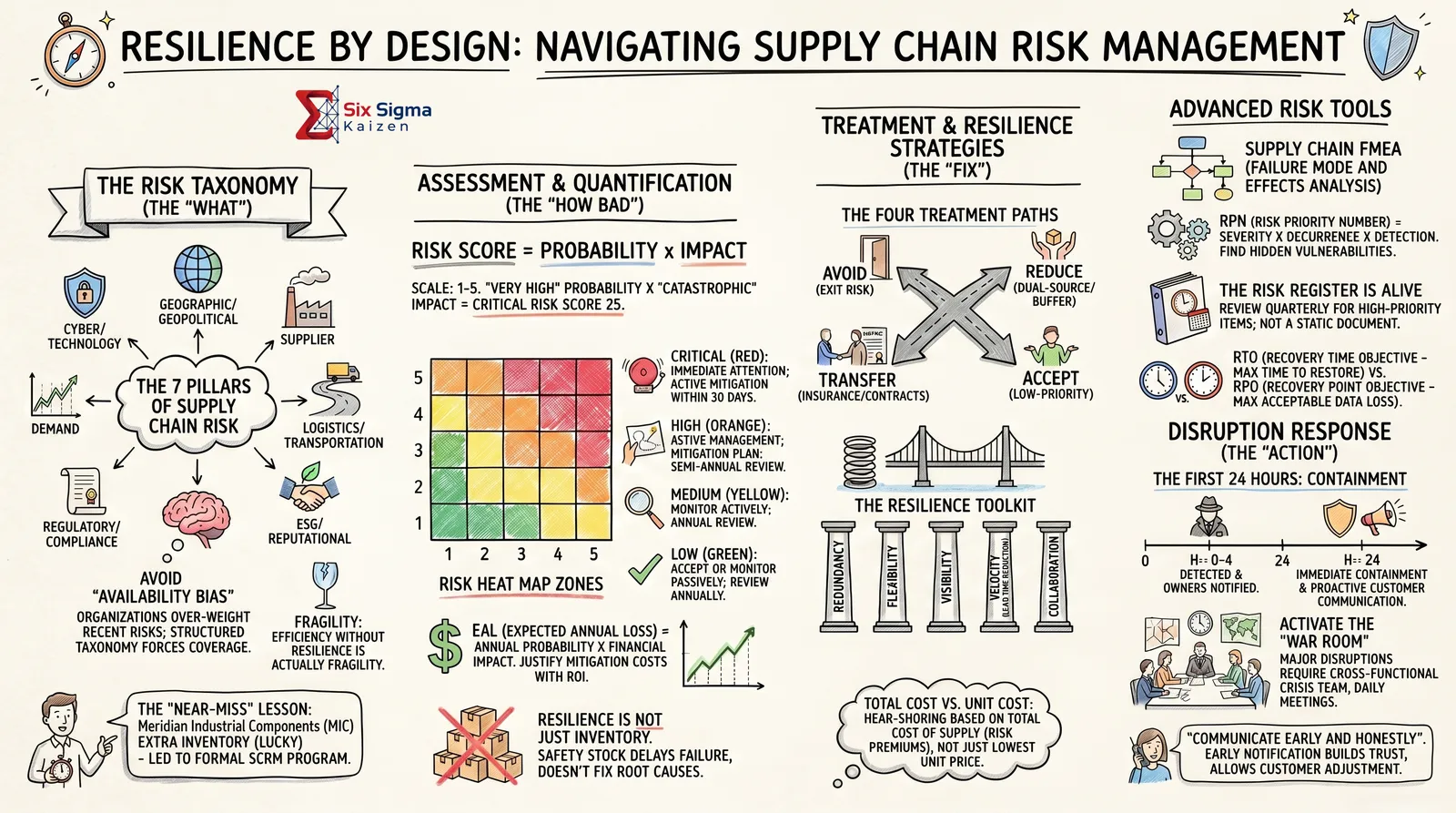

The resilience blueprint summarizes the end-to-end risk system: taxonomy, heat-map scoring, expected annual loss, treatment paths, resilience pillars, advanced tools, and the first 24 hours of disruption response.

Jump to Guide Sections

Introduction: Resilience Is Designed Before the Disruption

Resilience is not created by heroic expediting after a supplier misses, a port closes, a cyber event disables systems, or demand changes faster than the network can respond. Resilience is designed into the supply chain through visibility, redundancy, flexibility, velocity, collaboration, and disciplined response routines.

The most dangerous risks are often not the most recent ones. Availability bias causes organizations to over-weight the disruption they just experienced while ignoring supplier concentration, cyber exposure, demand volatility, logistics fragility, ESG exposure, and regulatory dependency. A formal taxonomy forces broader coverage.

Core principle: Efficiency without resilience is fragility. Safety stock can delay failure, but it does not fix root causes such as single-source dependency, weak supplier capability, poor visibility, or slow decision-making.

The Risk Taxonomy: The Seven Pillars of Supply Chain Risk

A risk taxonomy defines what must be scanned. It prevents risk reviews from becoming a narrow discussion of recent supplier misses and ensures that leaders look across demand, supply, logistics, technology, compliance, reputation, and structural network fragility.

Risk PillarExamplesTypical Early Signals
Demand RiskVolatility, forecast bias, promotion surges, customer mix shifts, demand collapse.Forecast error, backlog spikes, order cancellations, demand mix changes, customer expedite patterns.
Supplier RiskSingle source, quality instability, financial weakness, capacity shortage, sub-tier dependency.Late deliveries, rising PPM, delayed corrective actions, financial alerts, declining responsiveness.
Logistics / Transportation RiskPort congestion, carrier failure, lane disruption, capacity shortages, freight inflation, damaged goods.Transit variability, tender rejections, detention, claims, rising premium freight, weather or strike alerts.
Geographic / Geopolitical RiskRegional conflict, tariffs, export controls, natural disasters, political instability.Trade alerts, customs delays, regional risk ratings, supplier site exposure maps.
Cyber / Technology RiskERP outage, ransomware, supplier portal failure, EDI disruption, data integrity loss.Security alerts, failed integrations, backup failures, access-control gaps, incident reports.
Regulatory / Compliance RiskProduct regulations, forced labor rules, ESG reporting, safety, environmental, trade compliance.Audit findings, expired certificates, supplier declarations missing, new regulation triggers.
ESG / Reputational RiskLabor practices, environmental harm, unethical sourcing, public controversy, customer compliance gaps.Media alerts, NGO reports, supplier audit issues, customer scorecard concerns.

Assessment and Quantification: How Bad Is It?

Risk scoring converts vague concern into comparable priorities. The basic score is probability multiplied by impact. A 1-5 scale keeps the method simple enough for regular use while still separating low, medium, high, and critical exposure.

Risk score: Risk Score = Probability x Impact. A very high probability score of 5 multiplied by a catastrophic impact score of 5 produces a critical score of 25.
ZoneScore SignalManagement Expectation
Critical / RedHigh probability and high impact, or any event that can stop customers, safety, compliance, or revenue.Immediate attention, active mitigation, named owner, and action within 30 days.
High / OrangeMaterial risk requiring leadership visibility.Active management, mitigation plan, and semiannual review at minimum.
Medium / YellowMeaningful risk that may grow if conditions change.Monitor actively, maintain owner, and review at least annually.
Low / GreenLow probability, low impact, or manageable exposure.Accept or monitor passively with annual review.

Expected Annual Loss

Expected Annual Loss helps justify mitigation spending with ROI logic. EAL equals annual probability multiplied by financial impact. If a disruption has a 20% annual probability and a $1,000,000 financial impact, the expected annual loss is $200,000. A mitigation that costs $75,000 and materially lowers that exposure has a defensible business case.

Treatment and Resilience Strategies

Once a risk is scored, leaders must choose a treatment path. The right answer is not always more inventory. Some risks should be avoided, some reduced, some transferred, and some accepted because mitigation cost exceeds the expected exposure.

Treatment PathMeaningSupply Chain Example
AvoidExit the risk source or stop creating the exposure.Leave a supplier, country, material, product design, or service model when exposure is unacceptable.
ReduceLower probability, impact, or detection delay.Dual-source, add buffer, improve supplier capability, redesign packaging, strengthen cybersecurity, or qualify alternates.
TransferShift part of the financial or operational burden.Use insurance, contract clauses, service-level agreements, indemnification, or managed service partners.
AcceptMonitor and tolerate low-priority exposure.Accept low-probability, low-impact risks where mitigation cost is not justified.
Total cost view: Re-shoring, dual sourcing, and risk premiums should be evaluated on total cost of supply, not lowest unit price. A lower unit price can be a bad decision when disruption probability and recovery cost are ignored.

The Resilience Toolkit

Resilience is a portfolio of capabilities. The right mix depends on the risk type, impact, lead time, customer tolerance, and economics of mitigation. Overusing inventory is common because it is visible and immediate, but inventory is only one tool.

CapabilityWhat It ProvidesExample Application
RedundancyAlternate sources, lanes, equipment, sites, systems, or materials.Qualify a second supplier for a sole-source component or alternate carrier for a constrained lane.
FlexibilityAbility to shift production, routing, product mix, or materials quickly.Use flexible tooling, alternate BOMs, regional capacity, or multi-skilled labor.
VisibilityEarly warning and shared status across suppliers, logistics, inventory, and demand.Monitor supplier capacity, shipment location, risk alerts, and customer demand shifts.
VelocityShorter response and recovery time.Reduce lead time, speed approvals, pre-stage recovery plans, and remove decision bottlenecks.
CollaborationFaster coordinated action across suppliers, customers, carriers, and internal functions.Joint supplier continuity planning, customer communication protocols, and war-room routines.

Advanced Risk Tools

Basic heat maps prioritize risks. Advanced tools deepen the analysis by finding hidden vulnerabilities, quantifying recovery needs, and keeping mitigation work alive after the initial assessment.

ToolPurposeUse It When
Supply Chain FMEAAnalyzes failure modes across supply nodes, lanes, systems, and handoffs.You need to uncover hidden failure paths before launch, sourcing, network redesign, or major demand change.
Risk Priority NumberRanks failure modes using severity, occurrence, and detection.You need a structured comparison of failure risks and mitigation priority.
Risk RegisterTracks risk description, owner, score, treatment, actions, due dates, and review cadence.You need active management; review quarterly for high-priority items, not as a static document.
RTORecovery Time Objective: maximum acceptable time to restore a process or capability.You need to define how quickly a supplier, lane, system, or operation must recover.
RPORecovery Point Objective: maximum acceptable data loss.You need to define backup and data recovery needs for ERP, WMS, TMS, EDI, portals, or planning systems.

Disruption Response: The First 24 Hours

The first 24 hours of a major disruption determine whether the organization contains the event or creates secondary damage through confusion, delayed ownership, and poor customer communication. Response routines should be defined before the event happens.

Time WindowActionOutput
H=0-4Detect event, confirm facts, classify severity, and notify owners.Known issue statement, initial impact estimate, owner assignment, containment trigger.
H=4-24Contain immediate risk, activate cross-functional response, protect customers, and communicate proactively.Containment plan, customer communication, supply allocation, recovery scenarios, next update cadence.
H=24+Run war-room rhythm for major disruptions.Daily decisions, cross-functional action log, recovery timeline, escalation needs, lessons learned capture.
Communication rule: Communicate early and honestly. Early notification builds trust and gives customers time to adjust; late communication destroys options.

Meridian Near-Miss Lesson

Meridian Industrial Components learned that extra inventory can make a weak risk system look stable until the wrong risk appears. A near miss exposed that inventory had masked structural vulnerabilities rather than resolving them. The result was a formal SCRM program that defined risk categories, owners, scoring, mitigation plans, and response routines.

ObservationRisk LessonProgram Response
Extra inventory created a feeling of safety.Inventory can delay failure but cannot correct supplier, lane, or system root causes.Risk reviews shifted from stock levels to structural exposure.
Recent risks dominated discussion.Availability bias hid quieter vulnerabilities.Seven-pillar taxonomy forced broader risk scanning.
Mitigation spending was hard to justify.Leaders lacked financial comparison of exposure and mitigation cost.Expected Annual Loss was used to support risk ROI decisions.
Response ownership was unclear.Disruptions need defined owners before the event.Risk register, escalation rules, and war-room triggers were formalized.

SCRM Metrics and Review Cadence

Supply chain risk management should be measured like an operating process. The goal is not to create a risk document; it is to reduce exposure, improve warning time, and recover faster when disruption occurs.

MetricDefinitionManagement Use
Critical Risk CountNumber of red-zone risks currently open.Shows unresolved high-exposure items requiring leadership attention.
Mitigation Plan CompletionPercentage of mitigation actions completed by due date.Measures whether the risk register is active or just documented.
Single-Source ExposureSpend, revenue, or part count dependent on one supplier, site, tool, or material.Prioritizes dual sourcing, redesign, tooling, or continuity work.
Supplier Continuity Plan CoveragePercentage of strategic suppliers with reviewed continuity plans.Indicates readiness across the most important supplier relationships.
RTO / RPO ComplianceRecovery capability compared with defined recovery objectives.Validates whether processes and systems can recover within tolerance.
Disruption Response TimeTime from detection to owner notification, containment, and customer communication.Measures response discipline in the first 24 hours.
Expected Annual Loss ReducedEstimated exposure reduction from completed mitigation.Connects resilience work to financial logic.

Best Practices, Common Errors, and Tips

Risk Management Principles

  1. Use a formal taxonomy so risk reviews cover more than recent supplier misses.
  2. Score probability and impact consistently across categories.
  3. Assign an owner and review cadence to every meaningful risk.
  4. Use Expected Annual Loss to compare mitigation cost with exposure.
  5. Choose the correct treatment path: avoid, reduce, transfer, or accept.
  6. Do not confuse inventory with resilience; inventory is one tool, not a strategy.
  7. Keep the risk register alive with quarterly review for high-priority items.
  8. Define RTO and RPO for critical supply chain systems and processes.
  9. Prepare the first 24 hours of disruption response before the disruption occurs.
  10. Communicate early and honestly with customers when a disruption may affect them.

Common Failures

FailureConsequenceCountermeasure
Availability biasRecent disruptions crowd out structural risk thinking.Use the seven-pillar taxonomy during every review.
Static risk registerRisks are documented but not managed.Review high-priority risks quarterly and track mitigation actions.
Safety stock as the only responseFailure is delayed but root causes remain.Build redundancy, flexibility, visibility, velocity, and collaboration.
Lowest unit cost decisionsRisk premiums and recovery costs are ignored.Use total cost of supply and expected loss logic.
Late customer communicationTrust is damaged and customer options shrink.Predefine communication triggers, owners, and update cadence.
